Built a design and research team of 10, and made enterprise networking setup 5x faster
At a glance · Setup and team

The short version
Context
Cisco bought Viptela for SD-WAN. Its software needed fixing while a 2.0 redesign was planned, and we were 3 designers.
Ownership
Product Design Manager, 2017–2020, and hands-on designer of guided setup. Grew the team from 3 to 10 in San Jose and Bangalore; worked with 9 PMs, 6 TMEs and 200+ engineers.
What I did
Designed guided setup myself, split the team so fixes couldn’t stall 2.0, and set one way of working across two countries.
Impact
Setup went from 83 days to 2 weeks, and the team grew from 3 to 10 designers.
Business problem
Admins set up Cisco’s SD-WAN networks by hand, with command-line scripts and four tools, and it took 83 days.
The software we inherited from Viptela fit 15–20% of real networks, and 3 designers had to fix it while planning 2.0.

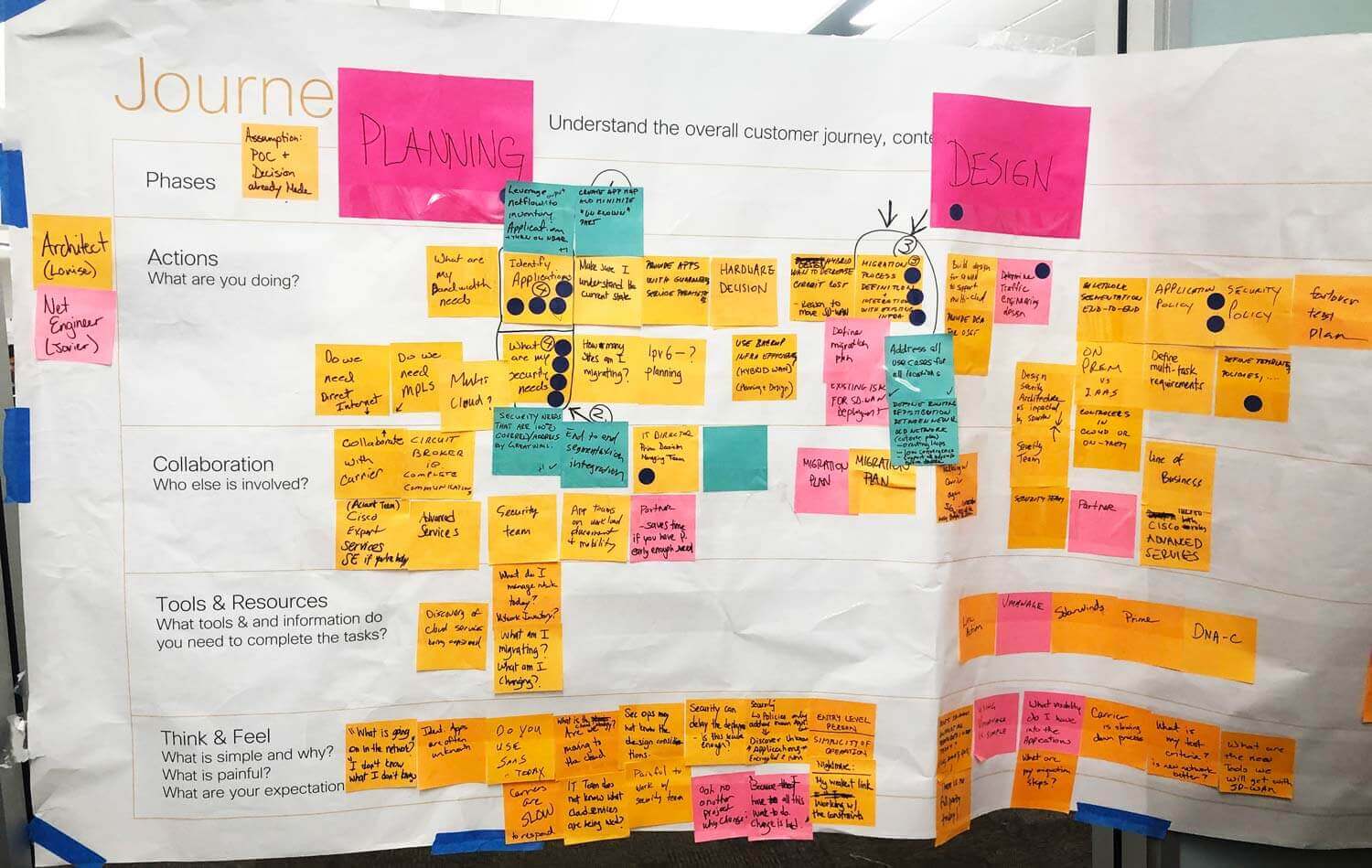

Field research

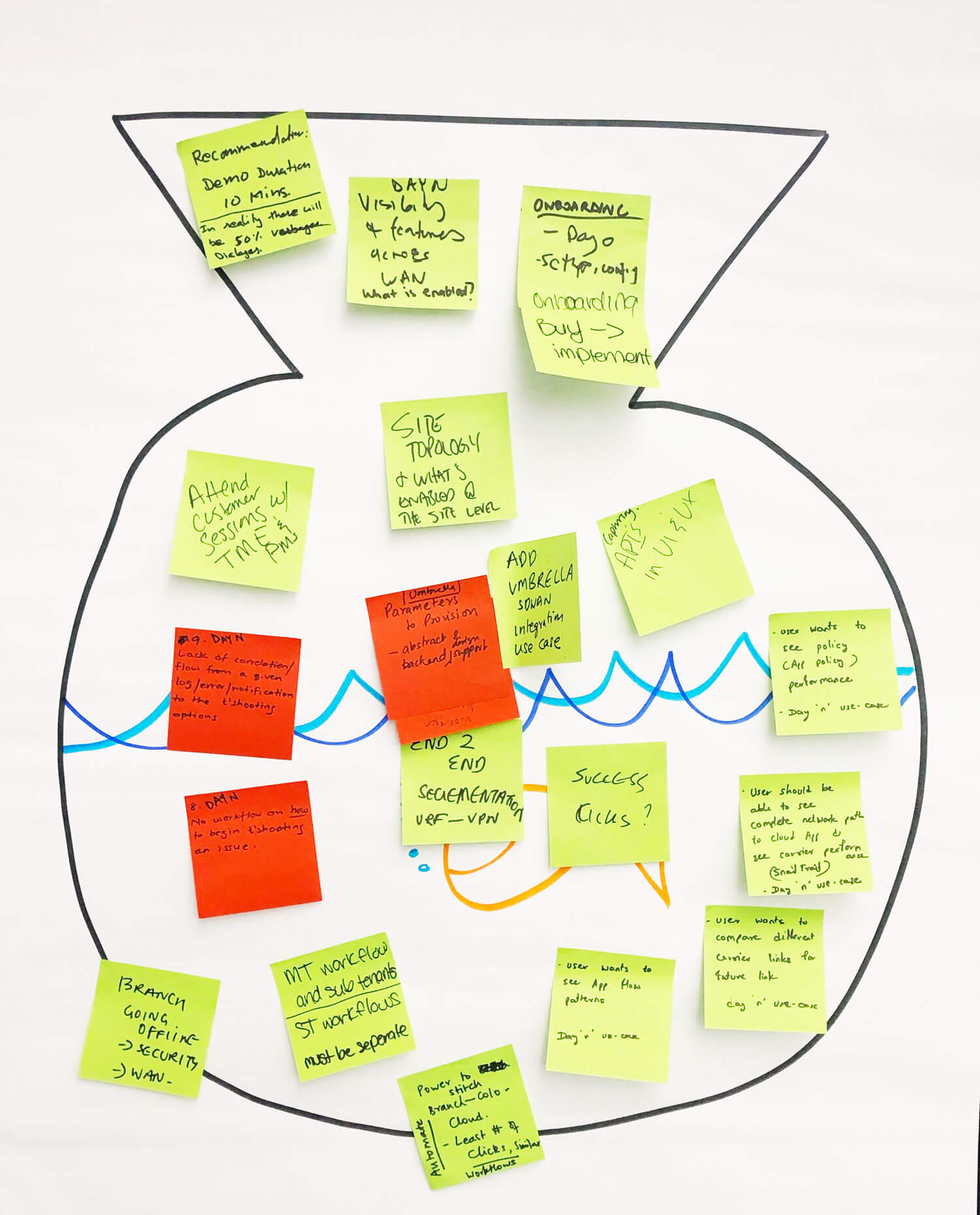

We spent three days with 14 customers
Along with 8 customer interviews and a survey of 300 internal users.

“There are just too many manual processes for setup and designing of our WAN network.”
Network admin at Wells Fargo, Cisco Live 2019
“Why do I need to use four different set of tools for my Day 0 network setup?”
System admin at Accenture, Cisco Live 2019
Success measures
Decision 01
Start setup from intent, not configuration

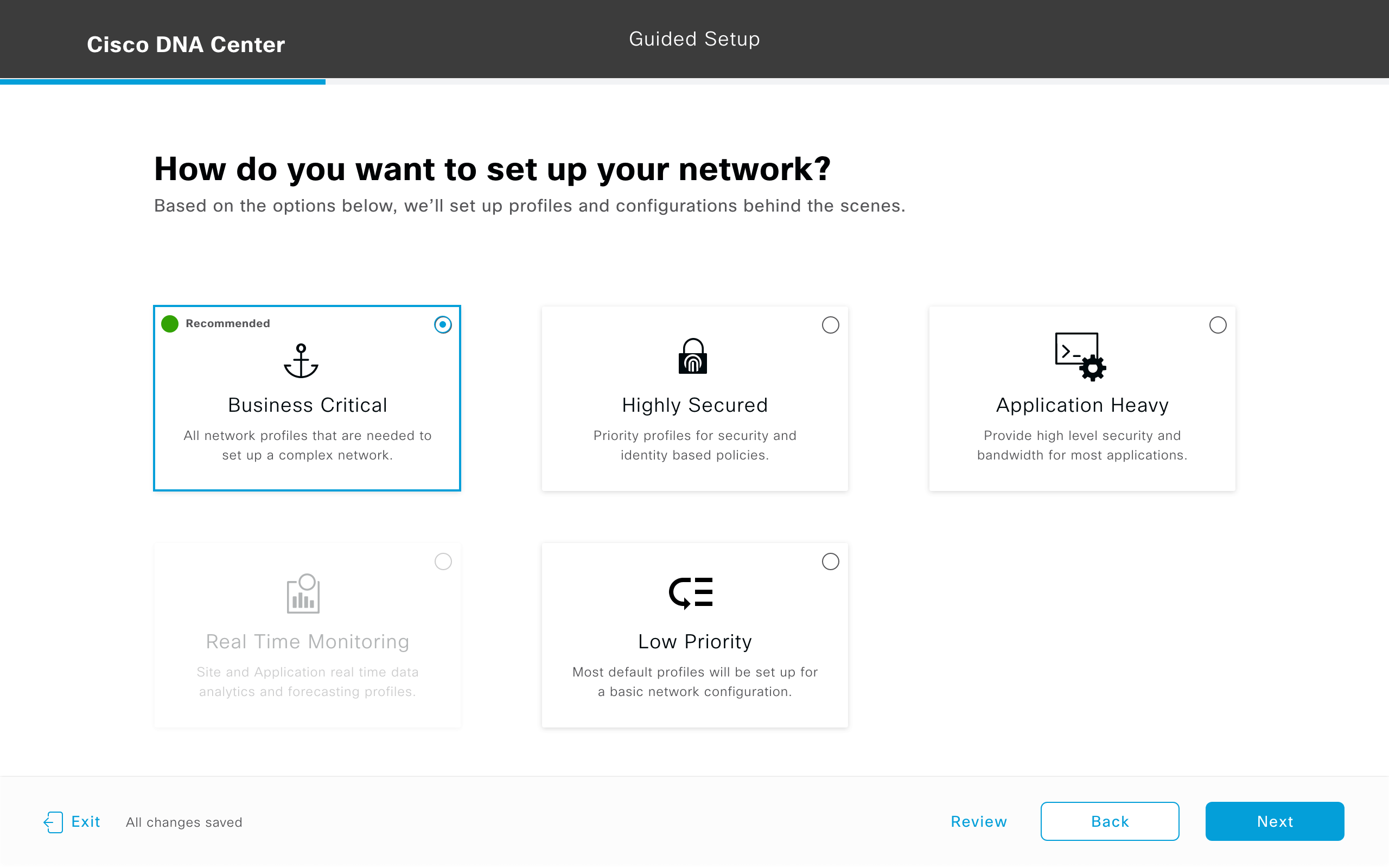

I designed guided setup myself: say how you want to run the network, and it finds, maps and secures it.
Success measure met

83 days to 2 weeksTo set up a network, with no command line.
From the 14 customers
Licensing inside setup
So setup stops at the contract’s device limit.
Decision 02
Split the team so today’s fixes couldn’t stall 2.0
I took a plan for two teams to our SVP in October 2018.
Challenge
One team doing both
Every urgent fix pulled people off 2.0.
Decision
One team for today, one for 2.0
Each with its own UI engineers.
Decision 03
One way of working in two countries
San Jose and Bangalore used the same kickoff, ownership and review.

Decision 04
Freeze designs at sign-off
Late changes kept slipping builds, so I agreed with PM, engineering, UI and TME leads: no UX changes after sign-off.
The cost
Some good ideas waited a release
Stable ground beat a better idea mid-build.
Leadership
I grew 3 designers to 10 in San Jose and Bangalore, and two of them were promoted.

Results
Impact of my work
Network setup
2 weeksDown from 83 days, without the command line.
Team
3 to 10Designers in two countries, working one way.
You Amaze award
2×In 2019, once for shipping SD-WAN while onboarding 4 designers.
Promotions
2Designers on my team were promoted.
Looking back
What lasted
Intent-first setup lasted.
It became the base of Catalyst Center.
What I’d do again
Split the team before it breaks.
One team for today, one for 2.0.
What I’d do differently
Put customers in every sprint.
And leave room after sign-off for the good ideas that waited.
What people say
“He really cares about his team and ensures everyone is included, engaged, inspired and motivated. I quickly realized his potential and he was the person whom I could always count on when the going got a bit rough.”
“He is inclusive, a good coach and knows how to get more from a team work. Calm and structured, he is a great professional.”
